- Soft strip / Demolition to all floors internally
- Demolition of existing Mansard and Flat roof structures
- Press mouldings to be taken of the existing Hall cornice detailing
- Careful removal of the Hall ceiling
- Asbestos removal; site wide
- Forming new structural openings and installing temporary works supports on all floors
- Demolition of the external bin hoist on the North Elevation
- Enabling works for the crane on the South terrace and required hoarding alterations
- Internal scaffold crash deck within library to facilitate roof demolition
- Demolition of existing slab and adjacent walls to facilitate the formation of a new lift pit in the north façade lightwell
Construction Works 21 October to 4 November
21 October to 4 November

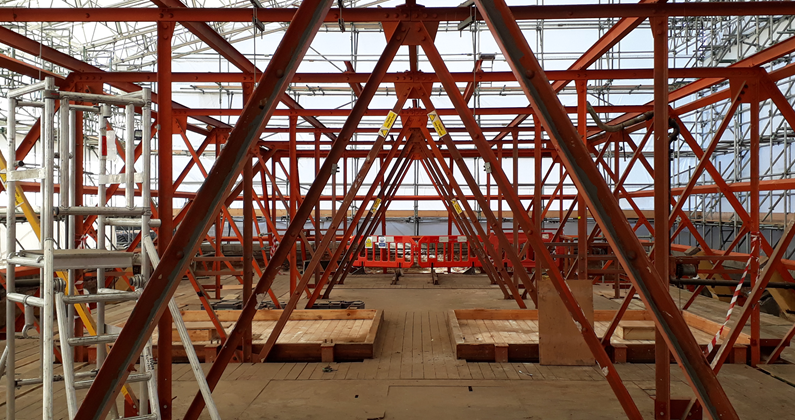

![21_removal_mansard_roof](https://www.innertemple.org.uk/wp-content/uploads/2019/10/21_removal_mansard_roof-795x420.png)
![21_removal_mansard_roof](https://www.innertemple.org.uk/wp-content/uploads/2019/10/21_removal_mansard_roof-290x172.png)
Removal of the Hall's Mansard Roof

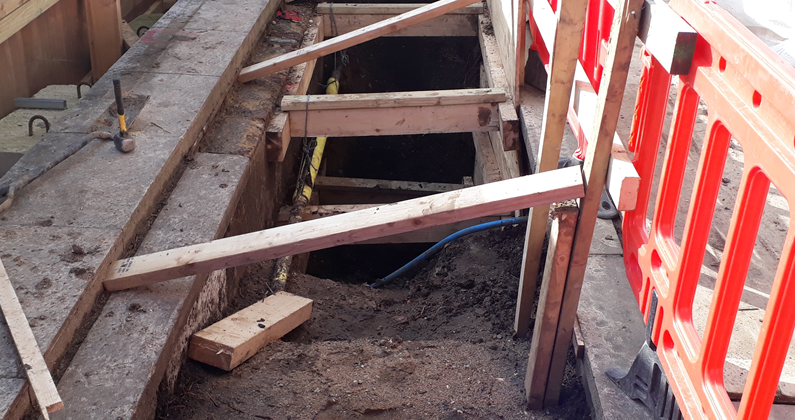

![Enabling Groundworks for the Mobile Crane](https://www.innertemple.org.uk/wp-content/uploads/2019/10/21_enabling_groundworks_mobile_crane-795x420.png)
![Enabling Groundworks for the Mobile Crane](https://www.innertemple.org.uk/wp-content/uploads/2019/10/21_enabling_groundworks_mobile_crane-290x172.png)
Enabling Groundworks for the Mobile Crane
Construction Works 21 October to 4 November
Location | Description of the Works | Noise Level |
---|---|---|
Ground Floor – Gents WC 24-25 October 2019 | Demolition of Small Masonry Staircase down to Low Level |
Amber |
Ground Floor – Gents WC |
Demolition of Toilet Cubicle Walls Adjacent to Francis Taylor Party Wall |
Amber |
External – New Lift Pit on North Façade |
Demolition of existing slab and adjacent walls to facilitate the formation of a new lift pit |
Red |
Mitigation Measures
- Installation of Noise Reducing Acoustic Blankets:
- At door openings
- At all windows locations.
- Works to be undertaken during Noisy Hours only
- Hand tools will be used to demolish the walls, as far as reasonably
practicable.
We're Building Something New
0:00
-0:00
Contact Us
SRM Special Projects Site Team offices are located within the Inn’s former Treasury Office, with access from the South Terrace where Reception Entrance signage can be found on the hoarding to assist. Please press the bell to attract attention.
Site working hours will be from:
8.00am - 6.00pm Monday-Friday
9.00am - 2.00pm Saturday
![John Walker](https://www.innertemple.org.uk/wp-content/uploads/2019/10/john_walker-185x185.png)
John Walker
Project Manager, SRM Special Projects
Detailsnavigate_next
John Walker
Project Manager, SRM Special Projects
![John Walker](https://www.innertemple.org.uk/wp-content/uploads/2019/10/john_walker-185x185.png)
John Walker
Project Manager, SRM Special Projects
Detailsnavigate_next
John Walker
Project Manager, SRM Special Projects
![John Walker](https://www.innertemple.org.uk/wp-content/uploads/2019/10/john_walker-185x185.png)
John Walker
Project Manager, SRM Special Projects
Detailsnavigate_next
John Walker
Project Manager, SRM Special Projects
Address
The Honourable Society of the Inner Temple
Treasury Office,
London EC4Y 7HL
